Site Guide

Sub-Base Preparation

The most important layer of the pour, and the one people rush.

← Back to Guides

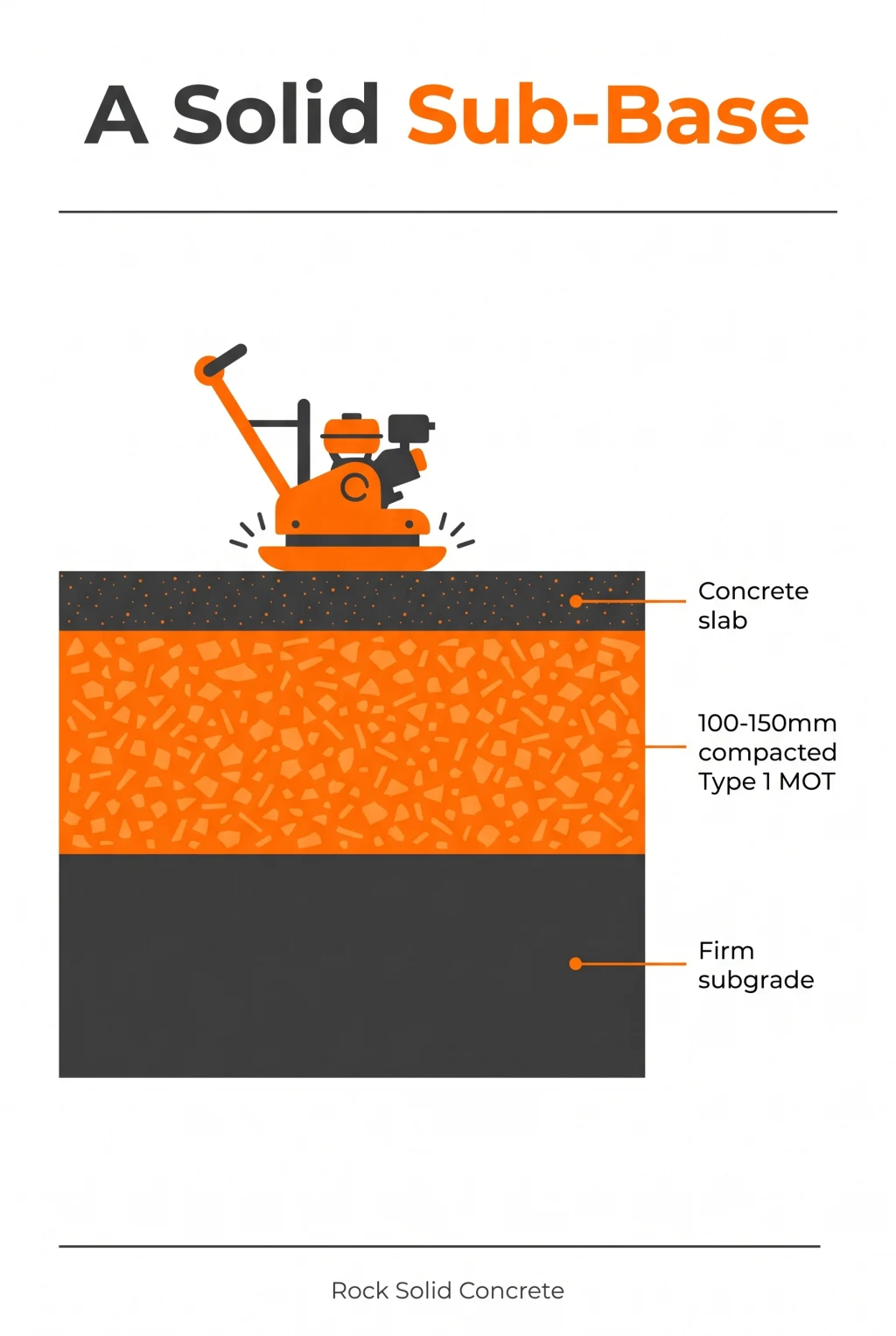

A good sub-base turns a hand-poured domestic slab into a 30-year driveway. A bad sub-base turns a structurally perfect C28/35 slab into a cracked mess within two winters. Concrete distributes load, but only if the layer below it holds firm.

What a Sub-Base Actually Does

Under your concrete slab, the sub-base does four jobs:

  • Spreads the load from the slab over a wider area of subsoil
  • Drains water away from the underside of the concrete
  • Prevents frost heave in cold winters by allowing water to drain below the frost line
  • Creates a stable, uniform bedding so the slab doesn't settle unevenly

Skip it, or do it badly, and the slab transmits point loads straight into soft soil, which cracks the slab as the soil moves under seasonal wet/dry and freeze/thaw cycles.

Type 1 MOT: The UK Standard

In the UK, "Type 1 MOT" (Ministry of Transport Type 1) is the standard sub-base aggregate. It's a graded crushed stone, usually limestone or granite, with particle sizes ranging from dust up to 40mm.

Why it works: the mix of fine and coarse particles means it locks together when compacted, leaving very little air space. It becomes a stable, semi-rigid layer that still allows water to drain through.

Alternative, Type 3

Less fines, more drainage. Used on permeable paving or where a SuDS-compliant surface is needed. More expensive per tonne.

Alternative, Crusher Run

Budget alternative. Can be fine for light-traffic domestic but doesn't match Type 1 for load-bearing. Avoid for driveways.

Avoid, Pea Gravel

Round particles roll over each other. Will not compact into a stable base. Don't use for structural applications.

Avoid, Builders' Rubble

Inconsistent sizes, may contain organic matter that breaks down. Short-term fix only; not a real sub-base.

How Deep Should the Sub-Base Be?

Depth depends on the load the slab will carry and the subsoil beneath:

Application
Sub-base depth
Slab depth
Shed / garden base (light)
100mm
100mm
Garden room / summerhouse
100-150mm
100mm
Hot tub base
150mm
150mm
Log cabin
150mm
150mm
Domestic driveway
150mm
150mm
Heavy-duty drive / RV
200mm
150-200mm
Farm yard (tractor)
225mm
150-200mm
Farm yard (HGV)
300mm
200mm

On clay or organic soils, go one step deeper on the sub-base. Clay moves through the seasons, and extra Type 1 helps absorb the movement before it cracks the slab.

Compaction: Where Most DIY Jobs Fail

Laying Type 1 is easy. Compacting it properly is where it goes right or wrong.

The golden rule: lifts of 50mm

Lay the Type 1 in 50mm layers and compact each layer before adding the next. A 150mm sub-base is three lifts, not one. If you dump 150mm in one go and try to compact it, the bottom 100mm stays loose, and that's where the slab fails.

The right tool

  • Wacker plate (vibrating plate compactor), the correct tool for 90% of domestic sub-bases. Hire for £30-£50/day. Don't skip this.
  • Pedestrian roller, overkill for shed bases, ideal for driveways over 40m².
  • Tamp by foot / stamping with boots, not adequate. Will not achieve proper compaction under load.

What "fully compacted" feels like

You know the sub-base is properly compacted when:

  • The whacker plate bounces slightly off the surface rather than sinking in
  • Your boots leave no visible print when you walk over it
  • A straightedge laid across it shows no dips larger than ~5mm
  • You can't push a screwdriver more than a couple of mm into the surface

Common Mistakes

1. Not digging deep enough

The dig needs to accommodate the full sub-base PLUS the slab. For a 100mm slab on a 150mm sub-base, you need to dig 250mm below your finished level. Topsoil must come out completely, never leave organic matter under the sub-base.

2. Leaving soft spots

If you hit a patch of soft, wet, or organic soil during the dig, remove it and fill with extra Type 1, even if that means going 300mm+ deep in one corner. A slab is only as strong as its weakest support point.

3. Skipping the geotextile on soft ground

On very soft subsoil, a geotextile membrane between the subsoil and the Type 1 stops the sub-base slowly sinking into the ground over years. Adds ~£1/m² and adds decades of life on problem ground.

4. Compacting a wet sub-base

Compacting Type 1 when it's saturated just creates mud. Let it drain first. Conversely, bone-dry Type 1 doesn't bind well, a light mist of water helps compaction.

5. No falls / no drainage

A sub-base that holds water breaks down faster. Build a slight fall (1:80 or so) into the sub-base, the slab's fall can follow.

Quick Self-Check Before You Pour

Before the concrete arrives, confirm:

  • Sub-base is the correct depth for your application
  • Laid in 50mm lifts, each compacted with a wacker plate
  • Surface is level to within 5mm with a straightedge
  • No soft spots, puddles, or areas that move underfoot
  • Correct fall for drainage built in
  • DPM laid over the sub-base before the pour

Sub-base ready? Get an instant price.
